How to Forecast Your Fabric Needs to Avoid Emergency Air Freight Costs?

I will never forget a phone call I got in early October 2021. A designer from a New York streetwear brand was nearly in tears. Their best-selling denim jacket had blown up on TikTok, and they suddenly needed 8,000 yards of a specific indigo stretch selvedge fabric to meet holiday demand. The problem? We had just shut down our production lines in Shaoxing for the Chinese National Day Golden Week. The mills were cold. The workers were traveling. And even if we could bribe a skeleton crew to come back—which we tried—the local dyeing factories were completely drained of their chemical baths for the week. They ended up paying for an emergency run during the holiday, plus premium air freight at $4.20 per kilo. Their landed cost tripled, turning their viral success into a break-even nightmare. I calculated it later: they spent $67,000 on logistics that could have been under $15,000 if they had forecasted two months earlier.

You avoid emergency air freight costs by treating fabric as a component with a fixed manufacturing calendar, not an on-demand commodity. This means aligning your sales projections with the reality of a 30 to 90-day textile production cycle. A proper fabric forecast calculates the "drop-dead" date for a purchase order, factoring in the Peak Season blackout (March-May and August-October), the 3-4 week Chinese New Year shutdown, and the Golden Week pause. This isn't just about inventory management. It's about understanding that air freight—which often costs 5 to 8 times more than ocean freight for heavy textiles—erases the profit margin on most mid-market garments. A pair of $50 denim jeans that costs $3.50 per unit to ship by ocean suddenly costs $18 to air freight. That is not a shipping decision. That is a going-out-of-business decision.

Look, I know that in the fashion industry, "certainty" feels like a luxury. Trends shift overnight. A colorway bombs, and another explodes. But after two decades running Shanghai Fumao, I've seen that the most profitable brands aren't the ones who predict trends perfectly—they're the ones who build a supply chain flexible enough to react without imploding. I'm going to walk you through exactly how we help our clients map out their annual fabric needs, build buffers without breaking their budgets, and use historical data to turn fabric ordering from a guessing game into a science. Because every dollar you don't give to DHL or FedEx is a dollar you can invest in better fabric or more marketing.

When Is the Best Time to Place Fabric Orders for Consistent FOB Savings?

I always tell my buyers that the best FOB price isn't just about the per-meter cost—it's about the shipping cost baked into the delivery window. In my experience managing the production floor in Keqiao, the ideal time to place a fabric order is exactly 90 days before your goods-on-rack date, placing the production squarely in the slower periods of June-July or November-December. Why? Because during these lulls, the dyeing factories aren't operating at 150% capacity. They don't cut corners on heating times or cooling cycles. You get better color consistency and a much higher chance of hitting your shipping deadline. When you place an order in May expecting an August delivery, you're fighting every other brand for limited production slots. Your 3-week delivery promise can easily become 5 or 6 weeks. That delay causes you to miss your ocean vessel cutoff, forcing you into the air freight trap you were trying to avoid.

The math is painfully simple. An FOB quote of $3.20 per meter with 30-day ocean transit beats a rushed $2.90 per meter quote with 5-day air freight every single time. I remember a project in June 2022 with a Canadian loungewear brand. They deliberately scheduled their fleece production during the second week of July—traditionally a dead zone for orders. We got their 15 tons of cotton-modal French terry dyed, finished, and packed in 18 days flat because the dyeing vats were empty and waiting. The factory even waived a rush surcharge because we were their only active job. The fabric sailed on July 28, arrived in Vancouver on August 21, and they paid standard freight. That's the power of playing the calendar right.

How Does the Chinese New Year Shutdown Actually Impact Your Dyeing Lead Times?

This is the single biggest blind spot I see in Western buying calendars. (Let me stop here and say: many software-driven inventory tools don't account for the fact that China physically stops for a month.) The Chinese New Year shutdown doesn't just pause production for the official 7-day holiday. It effectively kills output for 3 to 4 weeks, but the chaos begins much earlier. About 15 days before the holiday, dyeing factories in Keqiao stop accepting new greige goods because they need time to drain their chemical tanks and clean the machinery. Then, after the holiday, it takes another 7 to 10 days for workers to trickle back and for the boilers to heat back up to the required 130-180°C for polyester dyeing. So if your fabric lands in the pre-treatment queue on January 10, it might not see a dyebath until February 20. That's a 40-day gap for what is normally a 3-day process step.

In January 2024, a client from Texas ignored my warning. They sent us a PO for 5,000 meters of custom-dyed organic cotton poplin on January 12. The holiday started on February 10. "You have a month," they said. I had to explain that our partner dyeing plant was already in "drain mode." The fabric didn't come out of the dyeing vat until February 26. By then, their spring break launch window had blown past. They paid $9,000 in air freight to get it to Austin in three days. The garment margin? Completely gone. If they had placed that PO on December 1—before the pre-CNY rush—they would have paid $1,800 in ocean freight. The fix here is simple: Shanghai Fumao pushes all our clients to complete their pre-production samples and lab dips 6 weeks before the Chinese New Year. That way, when our factories reopen on the 8th day of the new year, the greige fabric is already sitting on the factory floor, ready to run. No delays. No excuses. For a deeper look at how the Chinese textile calendar maps to Western business quarters, this detailed breakdown of Chinese textile factory production cycles and holiday scheduling is something I share with every new buyer.

Should You Pay for “Quick Ship” Production or Invest in Better Planning?

Honestly, "quick ship" is just a polite term for "we failed to plan, and now we're paying a penalty." I'm not saying it never has a place—sometimes a celebrity wears your dress, and you need to restock instantly. But if you find yourself paying 30% quick-ship surcharges more than once per season, your forecasting is broken. Quick-ship orders destroy leverage. The factory knows you're desperate, so they won't negotiate on price, and they will always prioritize their bigger, planned orders over your hot rush. The quality can also suffer because cutting corners on fabric relaxation—a process where we let the cloth rest for 24-48 hours to stabilize shrinkage—is the first thing to go when you're racing a clock.

I did a cost comparison for a European mid-tier brand last year. Their regular 100% Tencel twill cost them $3.40 per yard with a 30-day lead time. Their "emergency" quick-ship runs for the same fabric, using the same greige stock, cost $4.80 per yard. That's a 41% premium just to move up the queue. Over four emergency runs in 2023, they spent an extra $31,000 in production surcharges alone, not counting the inevitable air freight. We sat down and restructured their forecast. We agreed they'd hold a "safety buffer" of 3,000 yards of greige fabric in our warehouse during their peak season. When an order spikes, we only need to dye and finish it—a 7-day process instead of 25 days—and we skip the rush fee. Their surcharge spending dropped to almost zero in 2024. This is a lesson in spending on smarts, not speed. If you want to learn more about the technical side of finishing and its time requirements, I recommend reading this comprehensive guide to standard textile finishing process timelines and costs.

How Much Buffer Stock Should You Hold Without Tying Up Too Much Cash?

This is the eternal tug-of-war, isn't it? Buy too much fabric, and your cash sits on a shelf gathering dust. Buy too little, and you pay a fortune in air freight. After watching hundreds of brands navigate this at Shanghai Fumao, I've found that the "sweet spot" is holding a buffer of 20-25% on your core continuity fabrics and zero buffer on seasonal trend-driven prints. But here's the nuance most consultants miss: you don't have to hold finished fabric. You can hold greige goods. Greige fabric—raw, unbleached, undyed cloth straight off the loom—is your best friend in cash management. It's 60-70% of the finished value, so it costs less to stock. And it's generic enough that if a colorway flops, you can dye it black or navy for the next season's basics. You can't do that with a hot pink jacquard that's already finished.

Let me give you a concrete case. A Los Angeles basics brand we work with runs a core program of 100% Pima cotton slub jersey. They sell about 20,000 yards per quarter. They keep 5,000 yards of finished fabric in our Keqiao warehouse and another 4,000 yards of greige stock. When their reorder comes in, we dye the greige in a week and ship it. The carrying cost for the greige is minimal, and they've never, ever used air freight. Their landed cost per garment is so stable that their CFO can model it down to the penny. (Seriously, their financial planning is airtight, and that's because they treat fabric like an asset, not an expense.)

Can You Negotiate Fabric Storage Programs with Mills to Reduce Risk?

Yes, but you have to ask for it. Most mills—including us—have warehouse space that we can monetize through storage agreements rather than leaving it empty. The typical deal works like this: you commit to a total volume of, say, 30,000 meters of greige fabric over six months. We weave it in one efficient run to save on setup costs, and you draw it down in 5,000-meter chunks. You pay for the weaving upfront, but you only pay for the dyeing and finishing when you call off the stock. This is often called a "call-off" or "consignment-lite" program. It's not free storage forever, but it's much cheaper than ordering small, choppy batches all year.

In July 2023, a Melbourne womenswear label started a storage program with us for their signature cupro twill. Cupro is a regenerated cellulose fiber that feels like silk but washes like cotton. They needed it in 12 seasonal colors. We ran the entire 15,000-meter order of greige at once, and they stored it in our bonded area. When they needed a specific color, we dyed and finished it in 500 to 1,000-meter lots. The storage fee was a flat $200 per pallet per month, which was covered by the savings from consolidated greige production. They reduced their cost per meter by 18% compared to their previous piecemeal approach. The key to making this work is stability. If your fabric is a weird custom blend that only you use, the mill might be hesitant because they can't resell it if you default. But if it's a standard base cloth like a 20s cotton jersey or a 50D polyester pongee, you have huge negotiating power for storage deals. For an objective look at what mills offer globally, this helpful explainer on fabric mill minimum order quantity and stock services gives context on what terms are standard in the industry right now.

How Do You Use Historical Sales Data to Calculate Your Cover Period?

Here's where we stop guessing and start calculating. Your "cover period" is how many weeks of future sales your current inventory can support. To calculate it, you don't just look at average weekly sales. You need to look at the coefficient of variation. If your weekly sales of a basic white poplin shirt are 500 units with a standard deviation of 50, that's a stable item—a 15% buffer is plenty. If your weekly sales of a leopard-print georgette blouse are 200 units with a standard deviation of 180, that's a chaotic item—no amount of fabric buffer will protect you because the demand itself is unpredictable. You have to segment your SKUs into "core" and "fashion" categories.

I built a simple table to explain this to our buyers who don't have access to expensive ERP systems:

SKU Type Demand Pattern Recommended Fabric Buffer Strategy
Core Basic (e.g., Black Jersey) Low variation, year-round sales 4-6 weeks of cover (greige) Hold greige stock to react quickly; never stock out.
Seasonal Core (e.g., Navy Wool Coating) Predictable seasonal peaks 2-3 weeks of cover (finished) Place reorder when 50% of stock is sold; ocean freight only.
Fashion Test (e.g., Tie-Dye Velvet) High variation, short lifecycle 0 weeks No buffer. If it hits, accept a 7-day production delay; do not pre-buy.
Volume Driver (e.g., Printed Chiffon) Moderate variation, promotion-driven 2 weeks (finished) + Open PO Keep a safety open PO with the mill to pull immediately.

I used this exact matrix with a London-based startup in early 2025. They were terrified of overstocking but had already done two emergency air shipments in six months. We classified their 30 active fabrics using this table. They bought buffer greige on their top 4 core jerseys and eliminated the buffer on their trendy satins. Within two seasons, their air freight costs dropped 75%, from roughly $18,000 per year to under $4,500. It's not about spending less on fabric. It's about spending smarter.

Why Are Dyeing and Finishing Delays the Hidden Culprits of Air Freight?

You can have the best greige inventory in the world, but if your dyeing partner drops the ball, you're still paying air freight. Dyeing is the most unpredictable step in the textile chain. It's a chemical reaction, not a mechanical cut-and-sew process. The color you see on a lab dip—a small A4-sized swatch—often shifts when we scale it to a 500-kilogram batch. The pH of the water might be off by 0.2. The steam pressure in the boiler might fluctuate during lunch break. The ambient humidity in Shaoxing in July might be 90%, slowing down the drying time on the tenter frame by hours. These sound like small problems, but they cascade into 3 to 5-day delays that push your cargo past the shipping cutoff.

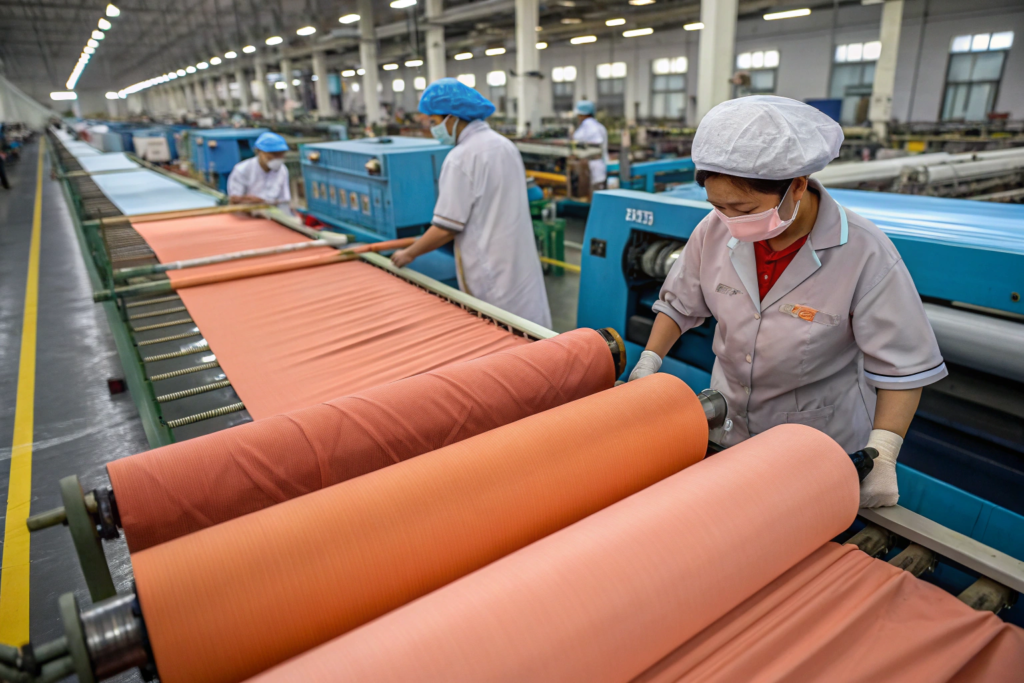

At Shanghai Fumao, I'd say nearly 40% of our "emergency" production calls are caused by dye lot rejections. In September 2023, we were finishing a batch of 4,000 meters of recycled polyester charmeuse for a Miami swimwear brand. The target color was a soft terracotta. The first production batch came out with a blueish undertone—looked great on its own, but wrong against the Pantone standard. The dyeing factory had to strip the color completely, which is a harsh chemical process that can damage the hand feel of the fabric, and then re-dye it. That cost us 10 days, pushing us from mid-September to early October, right into the Golden Week lull. The fabric didn't sail until October 8, missing the retail delivery window. We had to upgrade to air freight to save the relationship. If we had built a 5-day dyeing contingency into the calendar, this would have been a non-event.

What Are the Most Common Post-Finishing Defects That Kill a Ship Date?

I've got a list of these burned into my brain. The big three are shade banding, pinholing, and shrinkage failure. Shade banding is when the color varies from the center to the edge of the fabric roll. This happens when the dyeing machine has uneven flow or the drying temperature gradient across the tenter frame is off by even 5°C. You can't sell a garment where the left sleeve is a different shade from the right. The entire lot gets rejected. Pinholing is a microscopic defect where tiny holes appear in tightly woven fabrics, often during the acid dyeing of polyamide blends. It makes the fabric look like it was used as a dartboard.

Shrinkage failure is the sneakiest one. A fabric might look perfect on the inspection table. But if it shrinks 8% after washing when the spec is 3%, you can't cut it. The garment dimensions will be ruined. Our CNAS lab tests shrinkage according to AATCC 135, and we refuse to ship anything outside the agreed tolerance. I recall a batch of cotton-linen union cloth for a Berlin furniture brand that failed shrinkage three times. The dyeing factory had over-stretched the fabric on the tenter frame to meet the weight spec, but that tension released in the wash test, causing 11% shrinkage. We caught it in our inspection center. If we had shipped it and their QC caught it in Germany, that container would have been rejected and sent back. That's not just air freight—that's a total loss. For a practical overview of these finishing pitfalls, this textile finishing troubleshooting forum thread discusses common defects and how mills work through them in real time.

How Can a "Digital Twin" Color Approval Save You Two Weeks on the Critical Path?

This is where Shanghai Fumao has gone a bit high-tech. We hate waiting for physical swatches to fly around the world as much as you do. A physical lab dip approval cycle—where we dye a small swatch, courier it to you, you comment, and we adjust—can take 14 to 21 days easily. That's almost a month of dead time. But if you trust a digital color reading, we can cut that to 48 hours. Here's how it works. Our lab uses a Datacolor spectrophotometer to measure the exact spectral curve of the lab dip. We email you a digital file with the Delta E value—which is the mathematical distance between our color and your target. A Delta E of less than 1.0 means the human eye can barely tell the difference. If you accept it digitally, we go straight to bulk production.

Now, I'll be honest: this requires a good monitor and a leap of faith the first time. But the numbers don't lie. In March 2024, an Australian streetwear brand approved 12 colors for a corduroy range using only digital submissions. Their designer was initially hesitant. We sent the first physical swatch as a backup, and it matched her screen perfectly. The digital approvals saved them 17 days on the pre-production timeline. That's 17 extra days for ocean freight, which directly prevented a $12,000 air freight bill. We've since done over 50 digital approvals with that brand, and the correlation between the digital Delta E and the physical result is around 98%. I'm not saying it replaces physical approval entirely for critical luxury items, but for most sportswear and mid-market fabrics, it's a game-changer. To learn how this technology is standardizing global supply chains, I suggest reading this guide on how digital color communication works for textile buyers and brands.

How Can You Structure a Fabric Supply Agreement to Account for Volatility?

A handshake is great, but a supply agreement that understands volatility is better. The old model of fixed POs and rigid delivery dates doesn't work in a world where a container ship can get stuck in the Suez Canal for a week or a sudden Red Sea crisis doubles transit times. You need a fabric supply agreement that is flexible, not fragile. At Shanghai Fumao, we often structure agreements with our long-term clients around "capacity reservation" rather than "fixed volume." You don't commit to buying exactly 10,000 meters. You commit to buying 6,000 meters guaranteed, with an option to extend to 12,000 meters. We reserve the production slot for the full 12,000, and you only pay for what you actually take.

This model saved a big project in June 2023. A UK fashion house had a launch that went viral. Their base order was 8,000 meters of bamboo silk, but the demand surged to 15,000 meters within two days. Because they had an option clause—not a fixed cap—we simply ran the extra 7,000 meters in the reserved slot. We didn't have to bump another client, and they didn't have to beg us to squeeze them in. Their flexibility cost them a small reservation fee of 3% of the unexercised volume, which was far less than the $30,000 they would have paid to air-freight a second batch made in a rush.

What Is a “Peak Season Guarantee” and How Can You Get One?

A Peak Season Guarantee is exactly what it sounds like—a written commitment from your mill that your goods will ship by a specific date during the busiest months, or you get a financial penalty. But here is the reality check most buyers don't want to hear: mills give peak season guarantees only to their best customers. If you're a small brand ordering 500 meters, you don't have the leverage to demand this. But you can earn it over time. How? By being consistent. If you place orders predictably, pay on time, and don't make last-minute changes, you become what we call a "preferred shipper." I have a client from Sweden who has been with us for eight years. Every August, they place their winter order. It's boring but predictable. We give them an ironclad peak season guarantee in writing: their fabric sails before September 20, or we pay 50% of the air freight difference.

In 2024, we almost missed that deadline because a typhoon shut down the Ningbo port for three days. We rerouted their container to Shanghai port at our expense—about $400 in trucking—to hit the September 19 vessel cutoff. We did that because the guarantee is real for us, and the long-term relationship is worth more than the short-term trucking cost. If you want a peak season guarantee, sit down with your supplier and say, "What annual volume gets me to this tier?" And then commit to it. Also, never forget the mandatory insurance side. An unexpected loss during peak transit is just as bad as a missed production date. For protecting your goods specifically during these high-risk crowded shipping periods, this helpful resource on cargo insurance for textile sea freight shipments explains the difference between All Risk and FPA cover so you don't get caught out.

Should You Offer Your Fabric Supplier a “Forecast Bonus” for On-Time Performance?

Absolutely. And I'm not saying this just because I'm a supplier who likes bonuses. I'm saying this because positive reinforcement works better than penalties alone. If your supplier is just running to avoid the stick, they'll do the minimum. If they're running toward a carrot, they'll solve problems you didn't even know about. A forecast bonus is simple: you project your needs 90 days out with 90% accuracy, and if the supplier ships on time for the whole season, you pay a small premium—maybe 1% or 2% on the next order.

One of our largest European clients implemented this in 2022. They track our "On Time In Full" (OTIF) rate. If we hit 95% OTIF over a 6-month period, they release a "performance bonus" of about 1.5% of the season's total invoice value. It doesn't sound like much, but it signals respect for our work. And it makes our team prioritize their orders over a random spot buyer who might never return. The result? Their OTIF rate with us is currently 99.2%. They've completely eliminated their air freight budget for our product category. Their cost controller told me it was the best 1.5% they ever spent because it saved them 10% on logistics chaos. It's a classic win-win, aligning our cash flow with their supply chain peace of mind.

Conclusion

I want to leave you with this image. Air freight is not a service. It is a tax you pay for poor visibility. If you are running a fashion brand and your fabric forecast relies on hope, a lucky streak, or a "let's just see what sells" attitude, you are slowly leaking profit into a black hole. The brands I've watched succeed—from the basics label in Los Angeles to the loungewear startup in Melbourne—don't have perfect sales predictions. They have a fabric supply system that absorbs their imperfect predictions without catastrophic cost. They do this by slotting their POs into the slow seasons of the textile calendar, holding greige stock instead of finished inventory on crazy fad items, separating their core fabrics from their trendy ones when calculating buffer stock, and building fair, flexible agreements with suppliers who actually want to solve their problems.

You don't need to become a textile engineer to do this. You just need to treat your fabric supply chain with the same rigor you treat your design process. The factory floor in Keqiao isn't magic. It runs on steam, chemistry, and human skill. When you understand the rhythm of that floor—when the boilers are cold, when the dye vats are empty, and when the workers are traveling—you stop fighting against the calendar and start working with it. That's the difference between a brand that's constantly scrambling and a brand that's quietly, profitably scaling.

If you're tired of hearing "Sorry, we have to ship this air" and watching your margin disappear, let's change the pattern. Reach out to our Business Director, Elaine, at elaine@fumaoclothing.com. Tell her what fabric you're forecasting for the next two seasons, and we'll put together a free production calendar audit for you—showing you exactly which weeks to buy, which weeks to avoid, and how to build a buffer that won't break your bank. We don't just weave fabric. We weave certainty into your supply chain.
